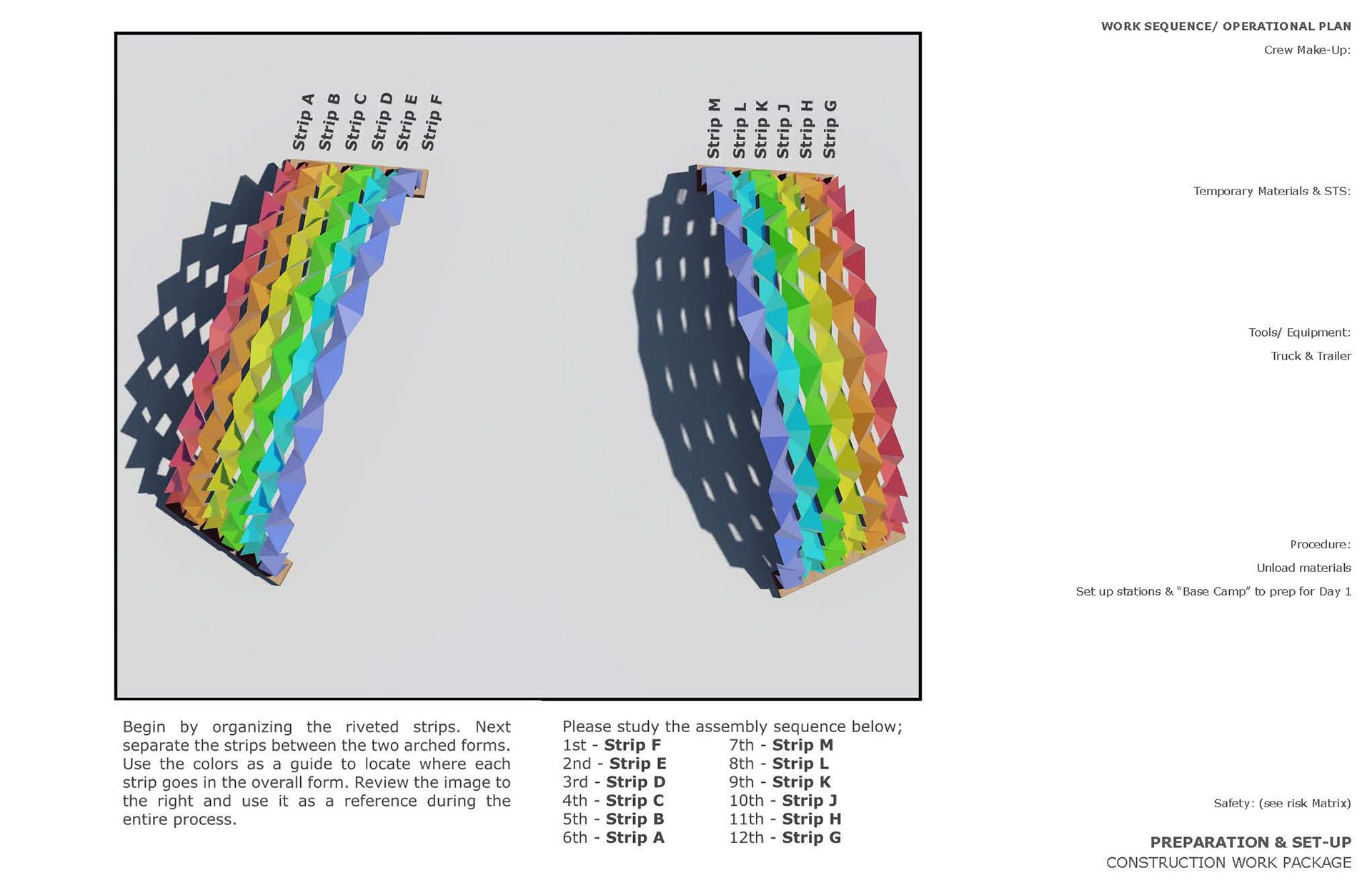

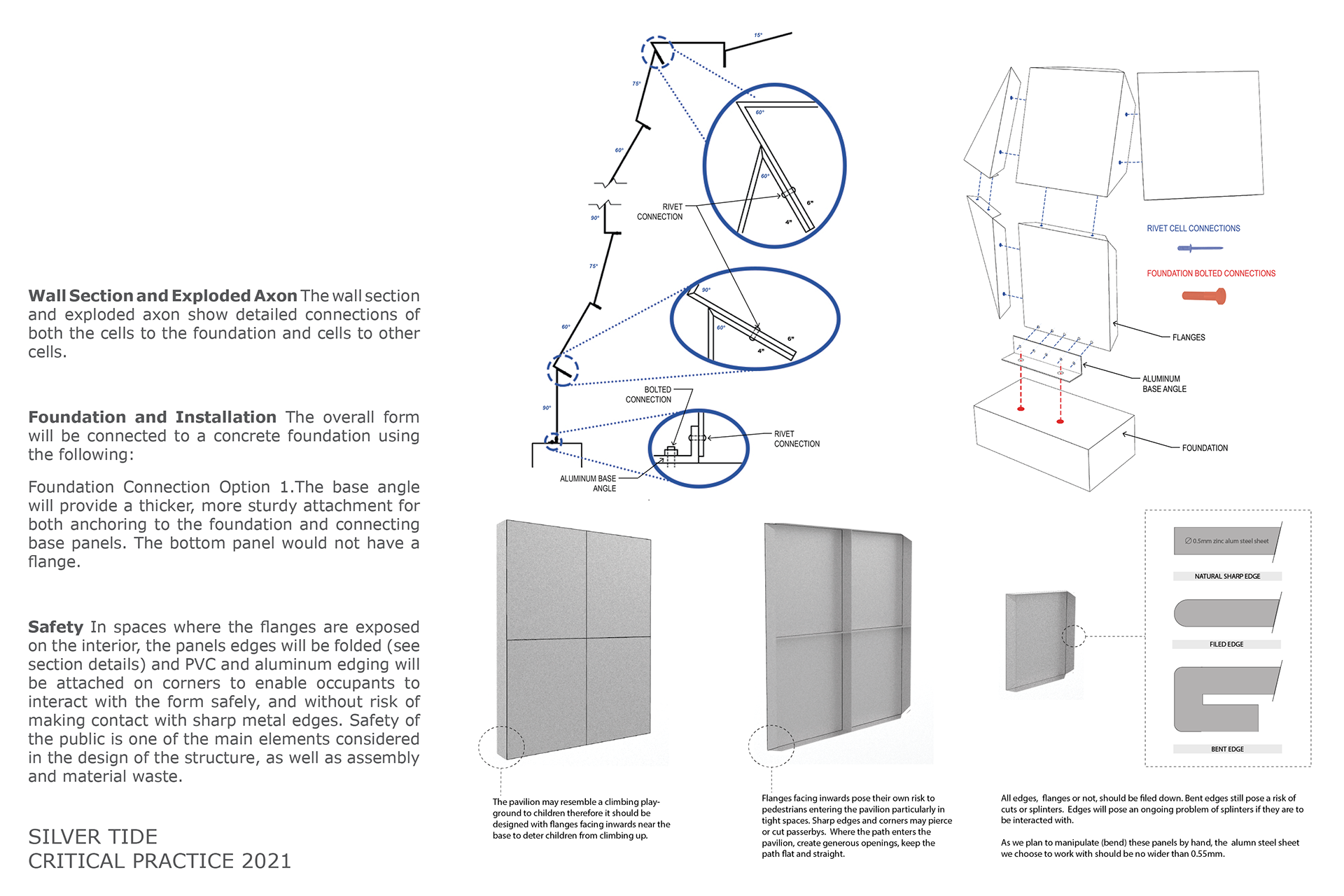

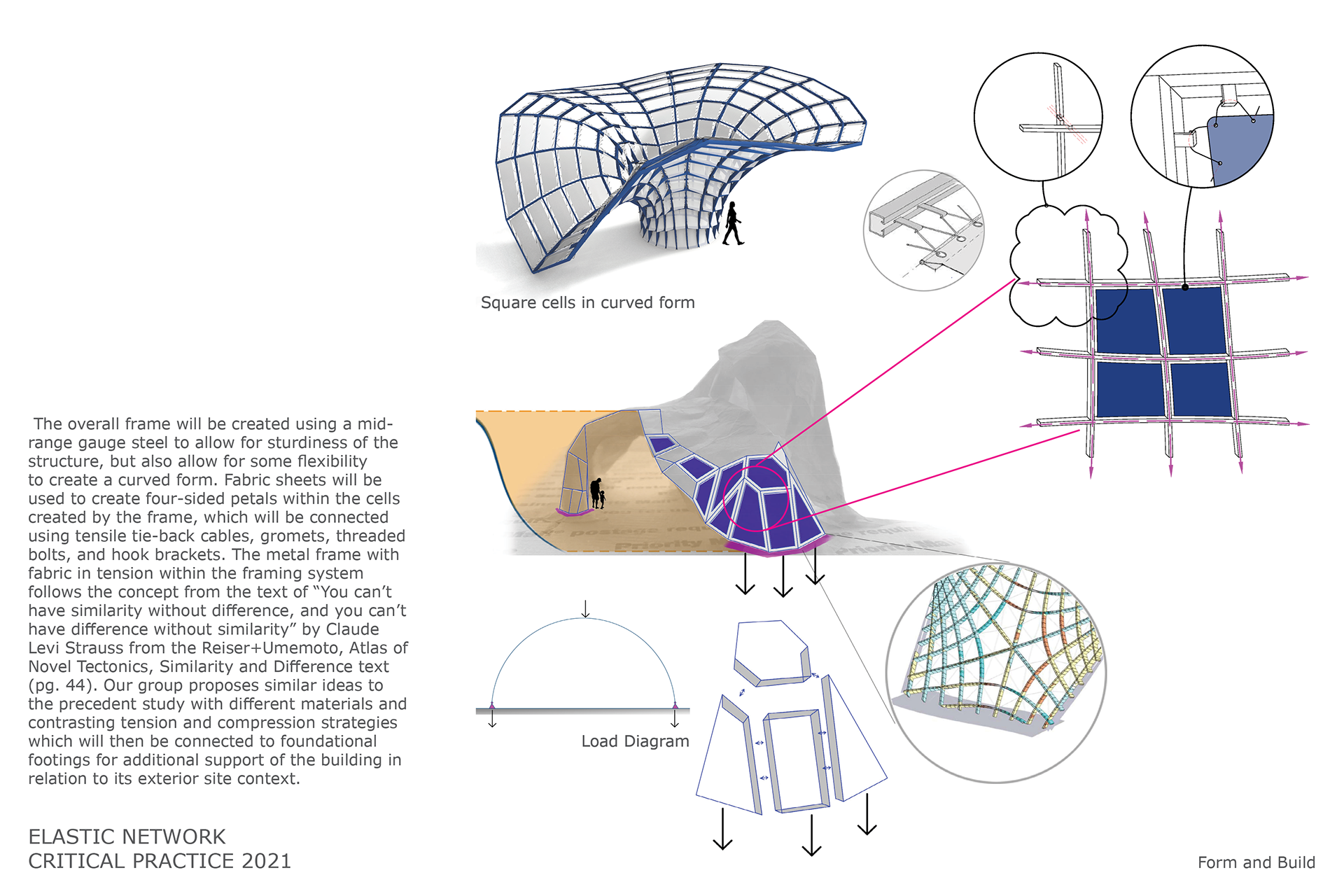

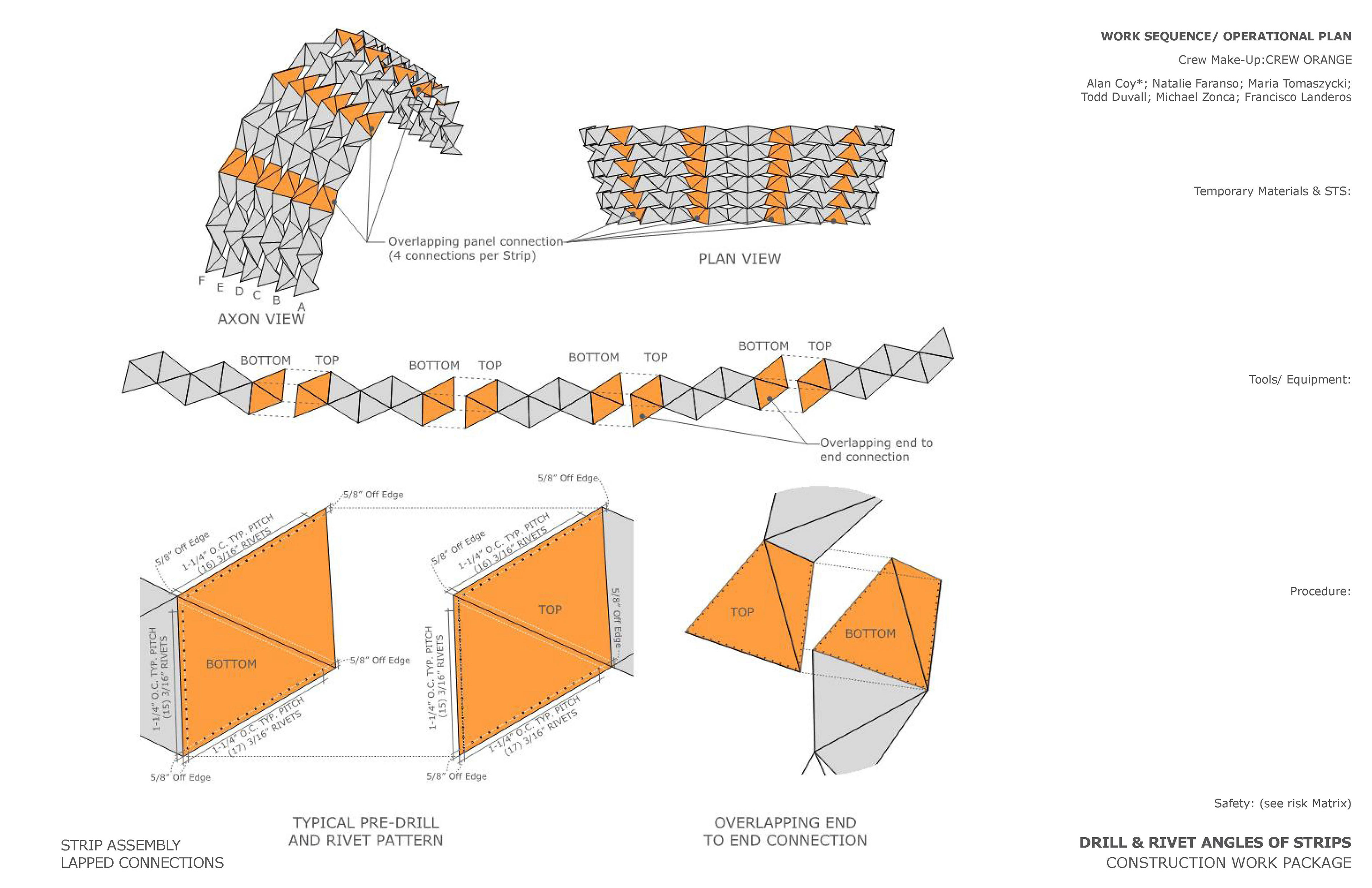

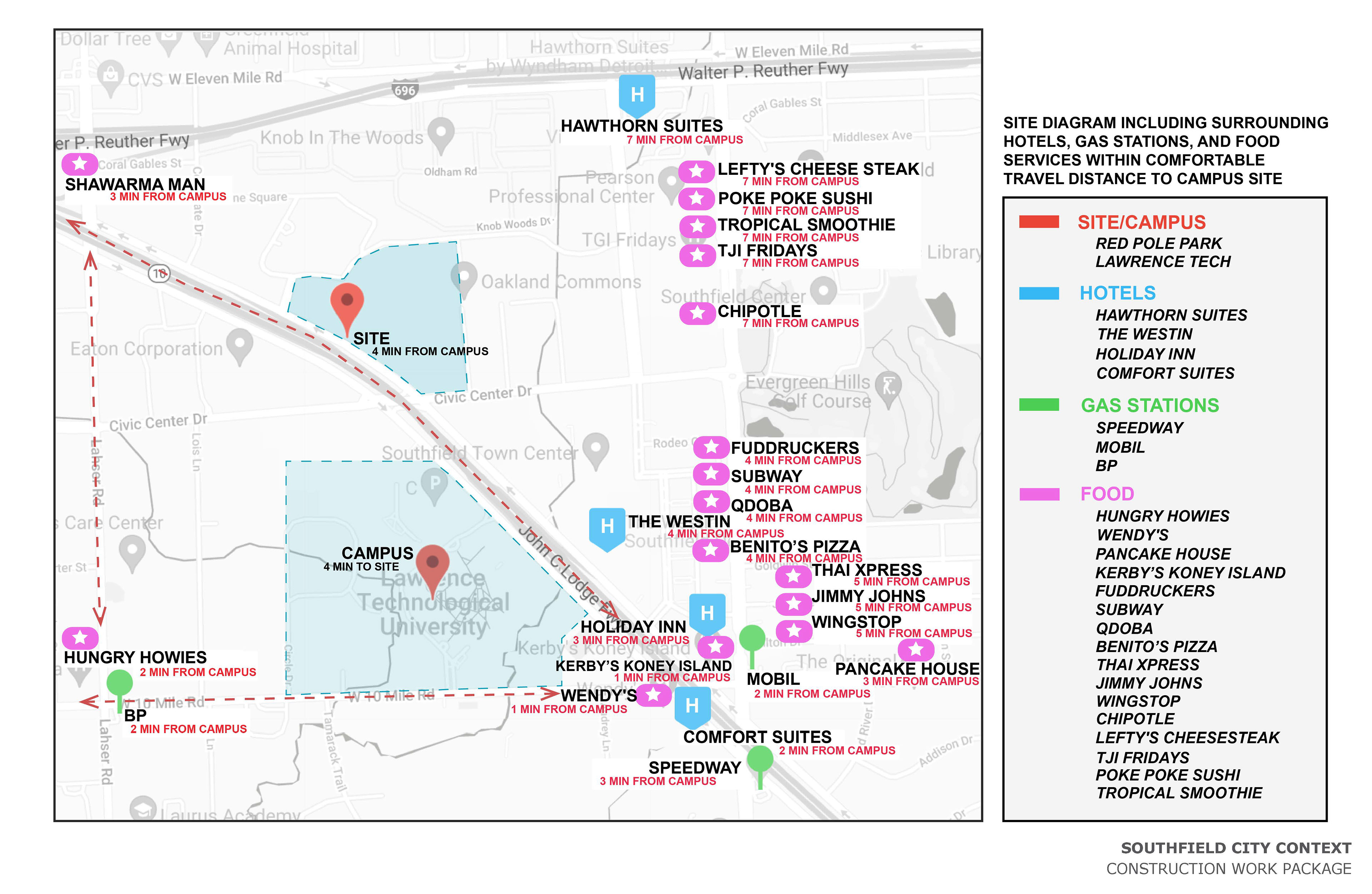

Completed during the summer 2021 semester, this project was completed in 5 phases, small teams work 01, combined teams work 02, designated project small teams work 03, designated project completion work 04, and build teams. during the first two phases of the project, I served as the team leader for both groups. During phase 3 I worked as a liaison between separate groups to improve communication among the class. I also served as a leader on the design team in an effort to finalize the project for build week.

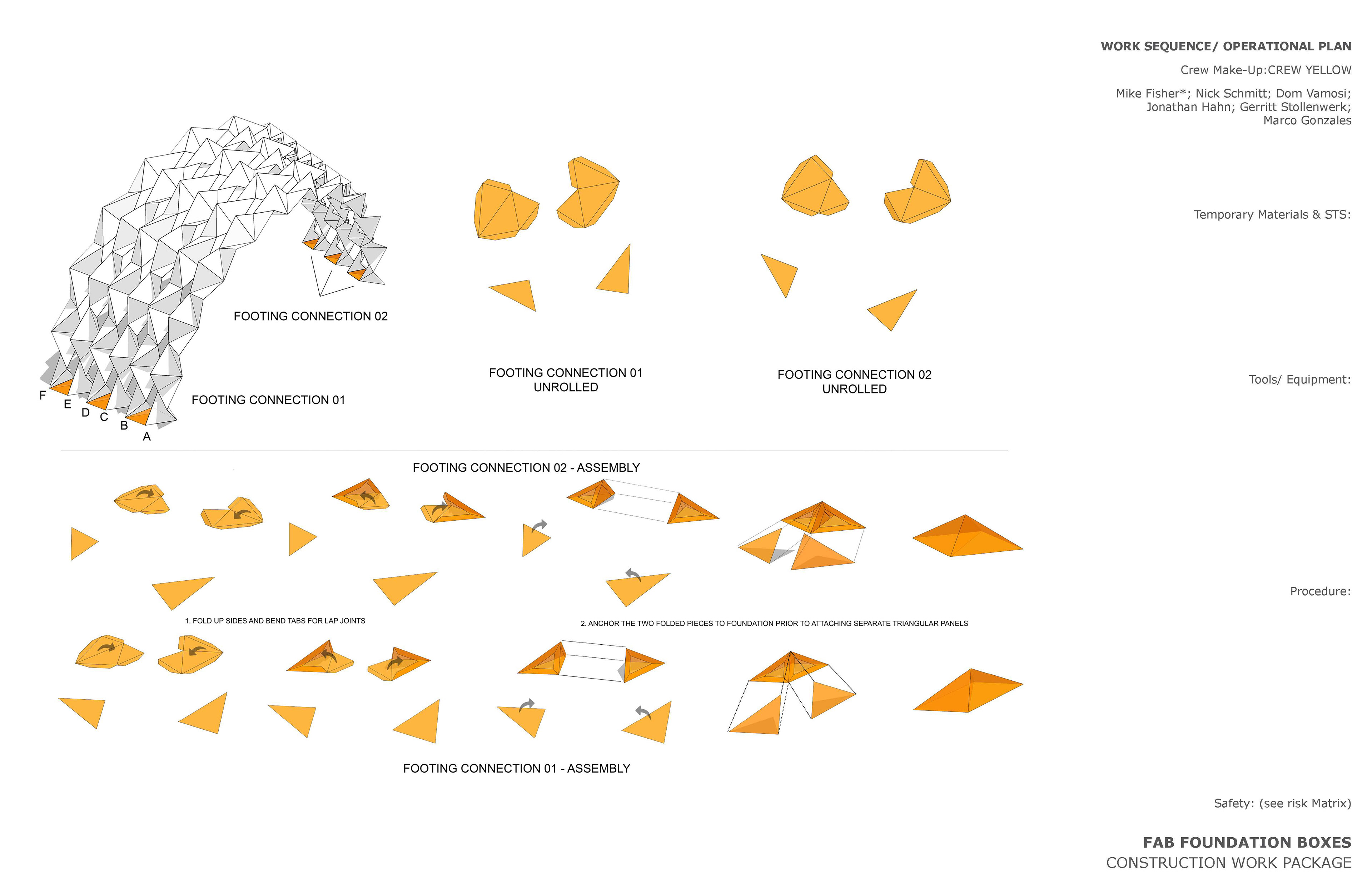

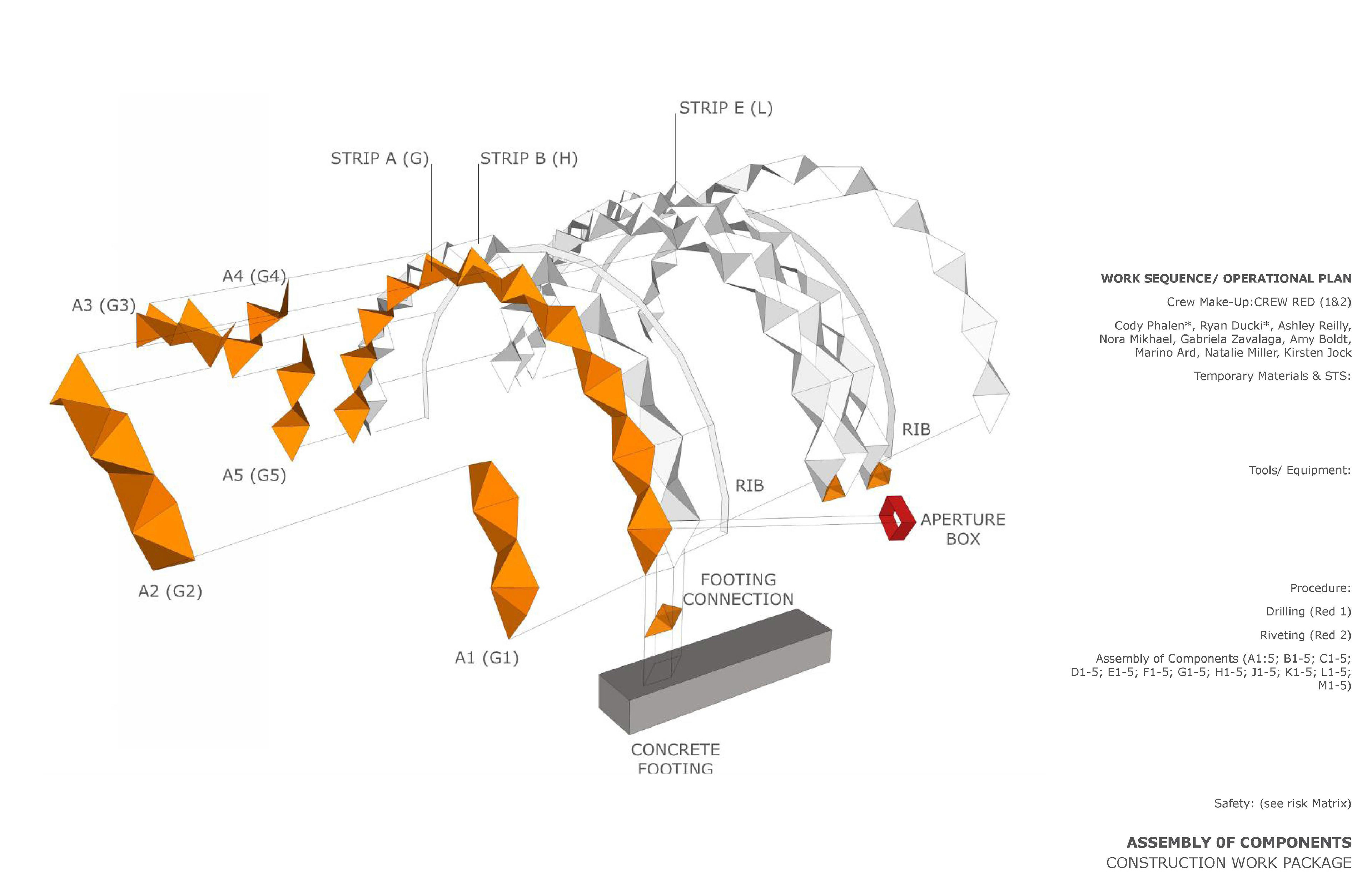

During the final build week, I was a member of team gold. our primary task was to build the foundation boxes for the arch. after completing this task within the first morning, our team went on to work on all other aspects of the project, including building the bending machine, bending sheets, riveting and constructing arches, painting, and placing and constructing the arch in place.
Phase 1: Small teams
Phase 02: Combined teams
Phase 03 - Build week

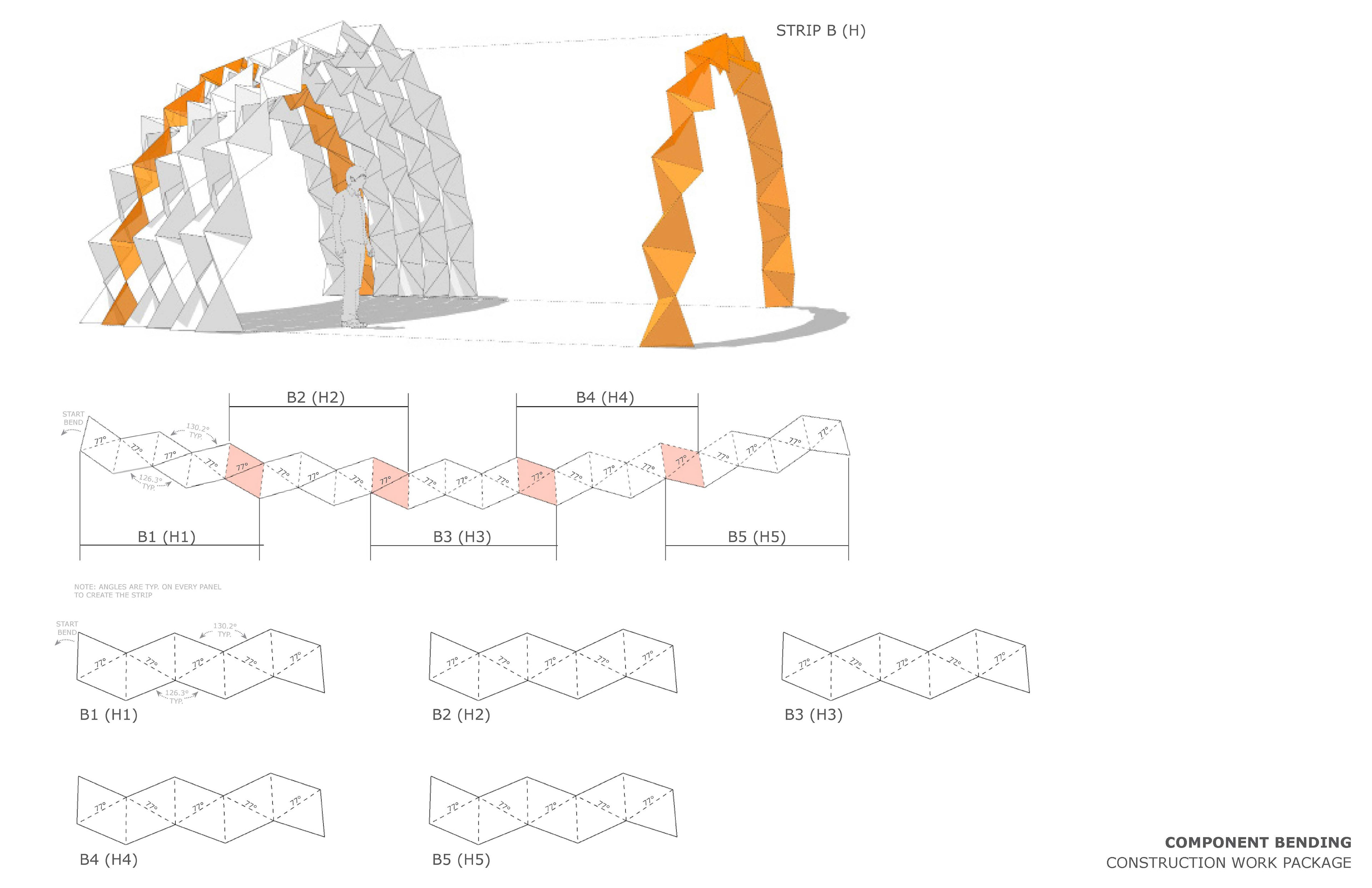

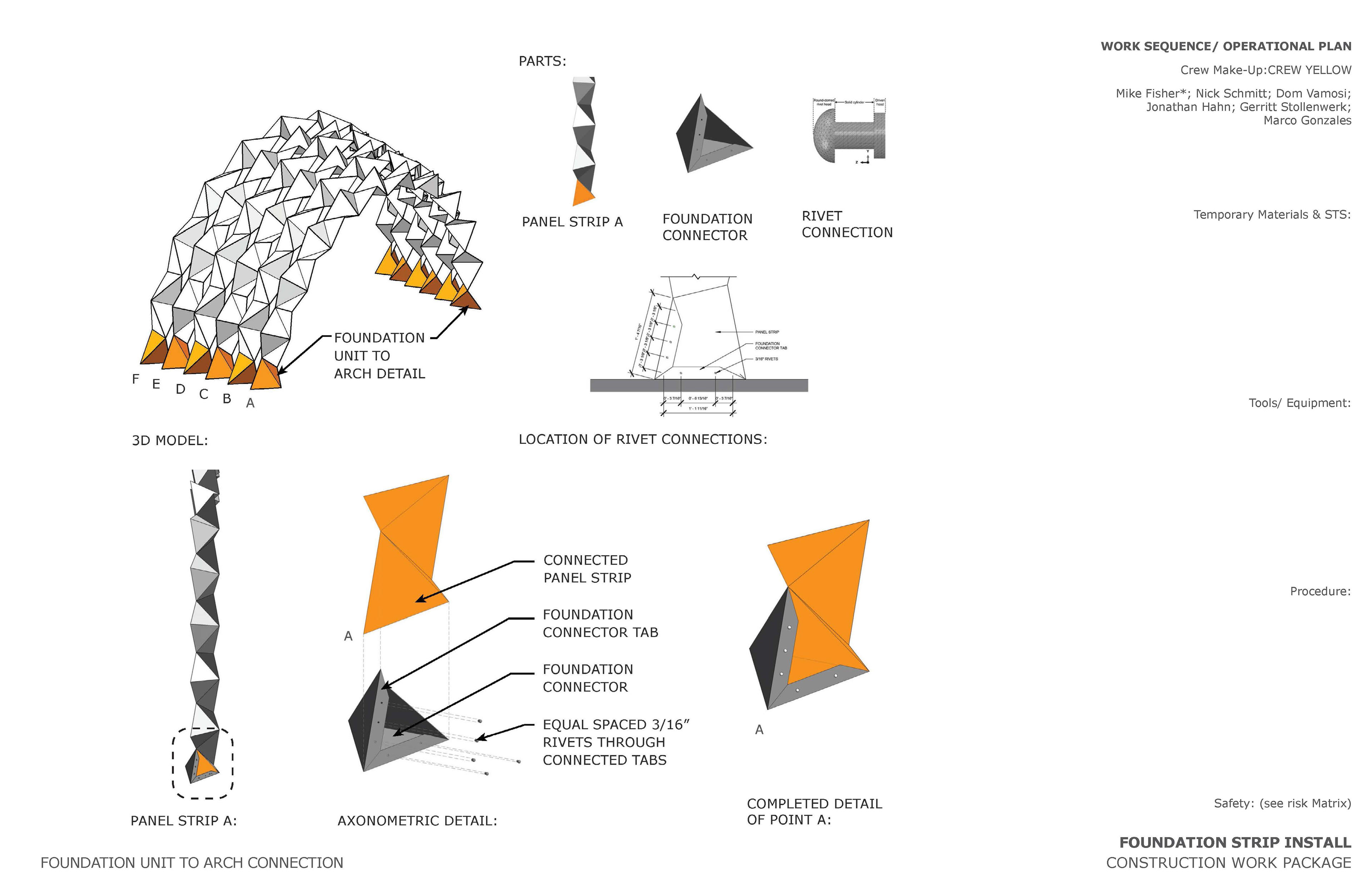

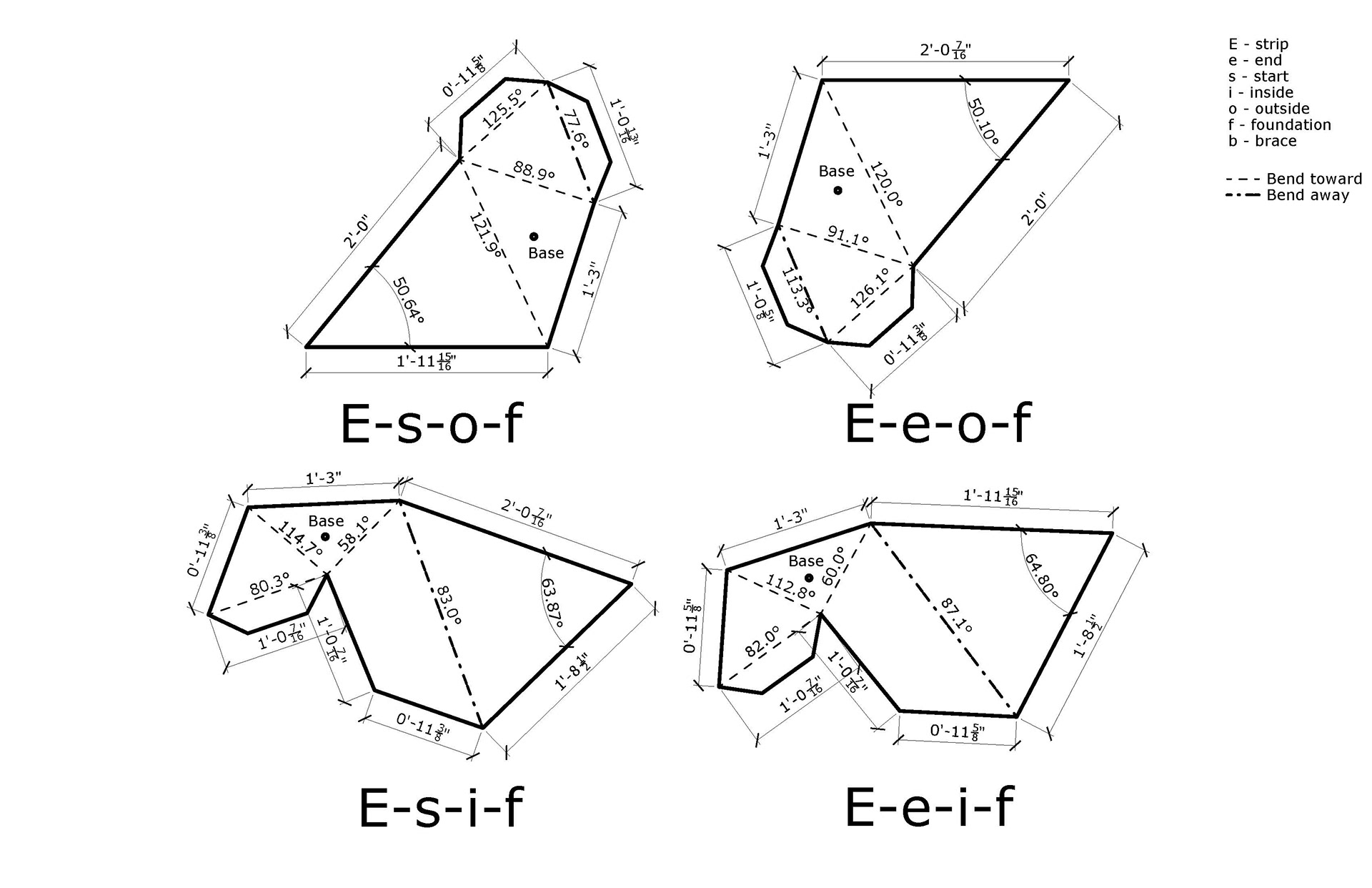

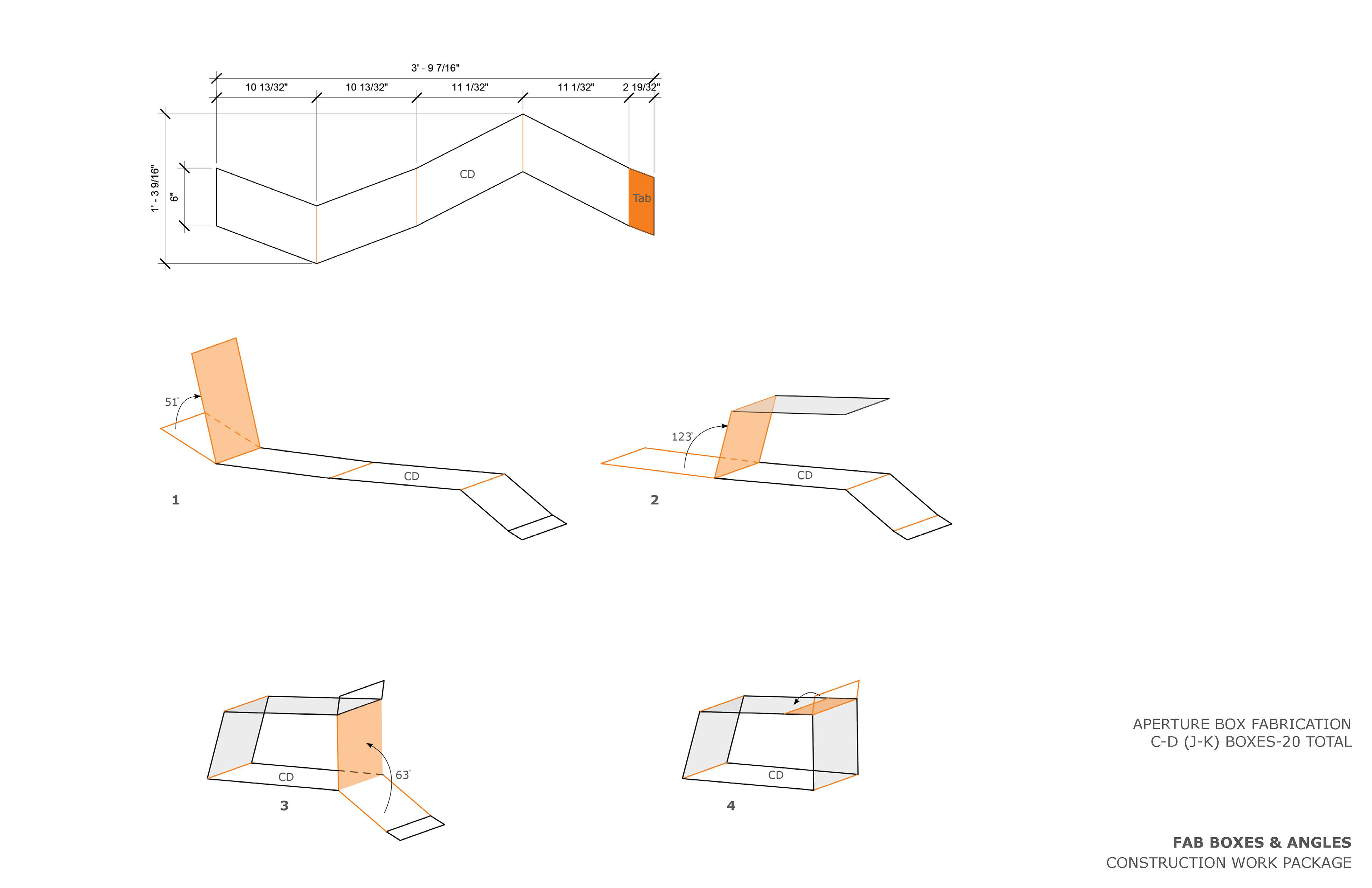

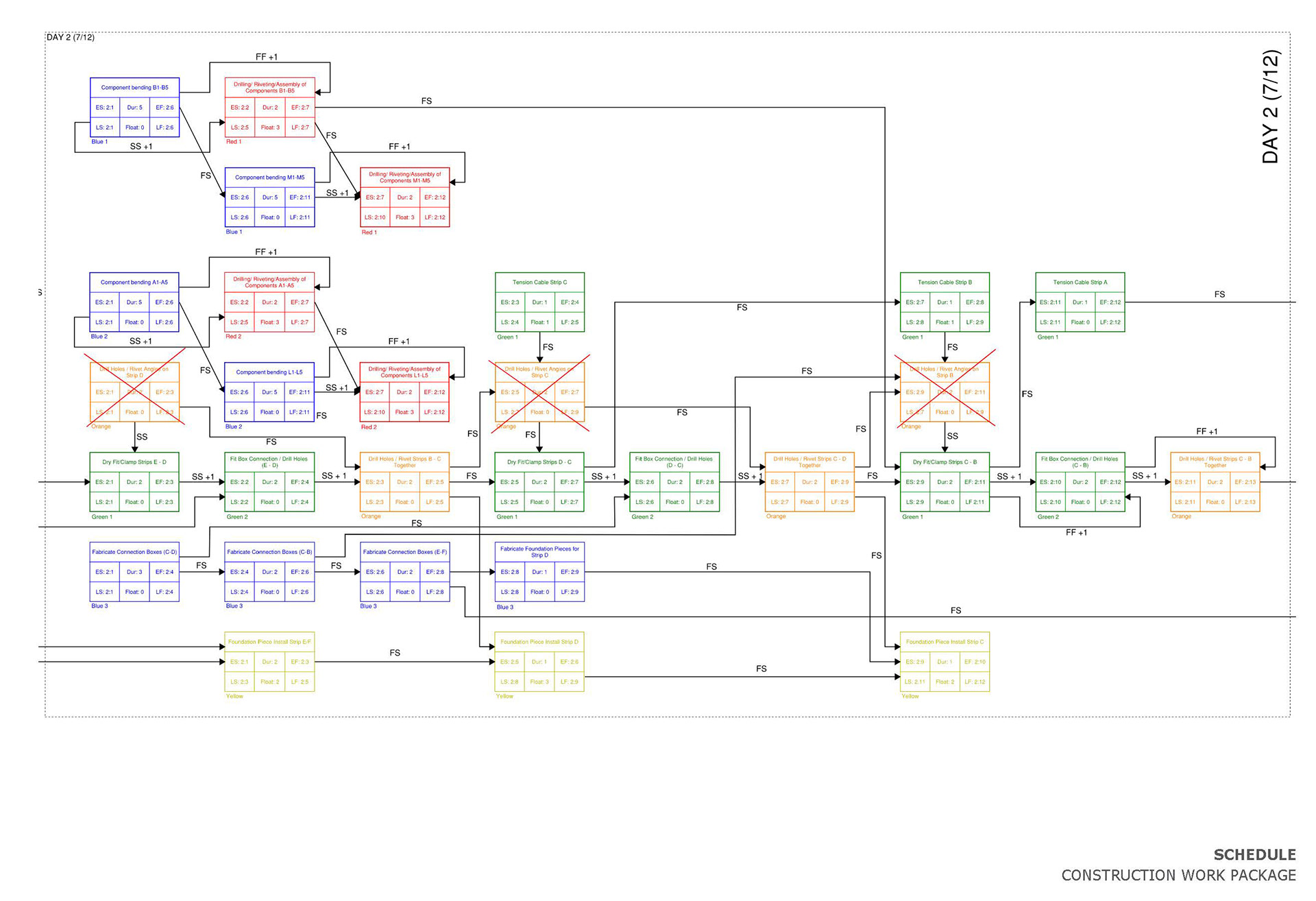

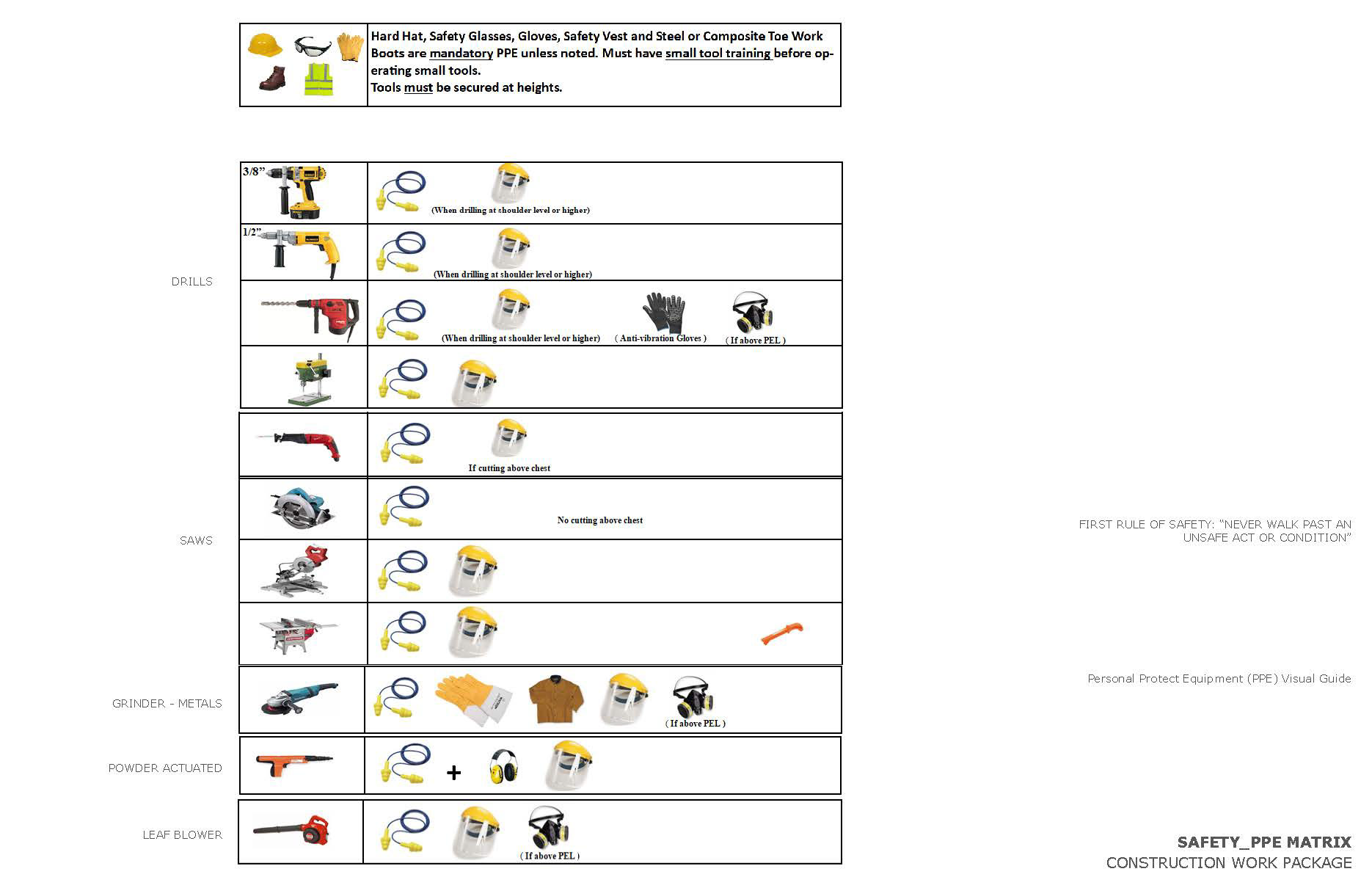

Construction documents given to build teams based on combined work of all groups

You may also like

Back to Top
